Construction Update: April 22, 2019

April 22, 2019

WORK PERFORMED THIS WEEK:

  •
  • Began detailing on stair no. 2.
  • Installed HVAC curbs on the roof. Shipped, staged and installed curtain wall steel, and installed decking on the east half roof.
  • Prepped and poured the second and third floor canopies.
  • Continued electrical overhead and in wall rough-in on the first and third floors. Wired up the VAV boxes on the first floor.
  • Continued underground feed for the generator power.
  • Tied in-roof drains on the second floor.
  • Continued layout and installation of VAV duct/boxes on the third floor. Worked on mechanical chases and RTUs.
  • Continued interior wall layout, erection of studs and installation of door frames on the first and third floors. Continued layout of the fourth floor.
  • Continued spray foam insulation on exterior wall.
  • Continued fireproofing the west and east half steel.

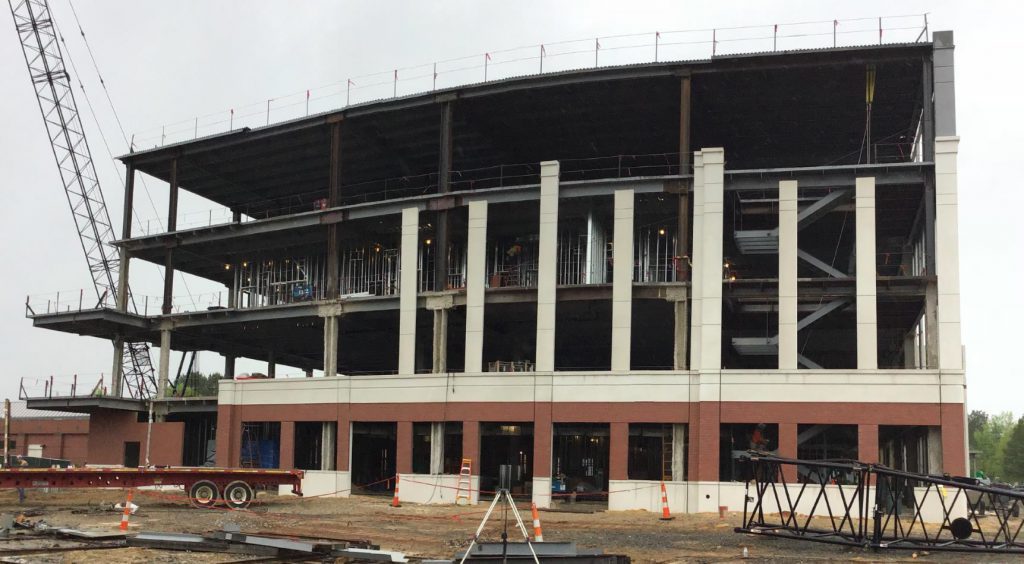

  • Continued hanging west side precast. Shipped and staged precast.
  • Delivered new crane.
  • Continued caulking between the precast.
  • Continued installation of window frames.

STATISTICS:

  • The concrete and brick façade currently being installed is composed of 373 individual panels. These are cast at a plant in Ashland City, Tennessee and delivered via trucks to the site.
  • The panels are hoisted using cranes and welded back to the concrete and steel structure, fitting together like a large and heavy jigsaw puzzle. The largest panel weighs approximately 25,000 pounds.
Campbell Clinic Facility Expansion

For appointments call
901-759-3111
